Cryogenic Containment

How membrane containment systems demonstrate compliance with IMO standards

How membrane containment systems demonstrate compliance with IMO standards

Author

Cryogenic Shipping Strategist

Time

Sep 11, 2026

Click Count

Compliance is not demonstrated by the presence of a membrane tank alone. It is demonstrated when the complete cargo containment arrangement can be shown to control cryogenic leakage, structural movement, insulation performance, vapour hazards, and emergency consequences throughout the vessel’s operating life. For LNG carriers, this means the membrane, insulation spaces, hull structure, secondary barrier, monitoring arrangement, and operating procedures must work as one verified system.

Membrane containment systems IMO standards are therefore assessed through evidence: approved design documentation, material qualification, controlled fabrication, inspection records, functional tests, and operational arrangements that remain effective after delivery. A tank may appear well built during a visual inspection yet still present an unacceptable risk if its secondary barrier continuity, interbarrier monitoring, weld quality, or cargo-pressure response cannot be demonstrated.

What IMO compliance means for a membrane LNG containment system

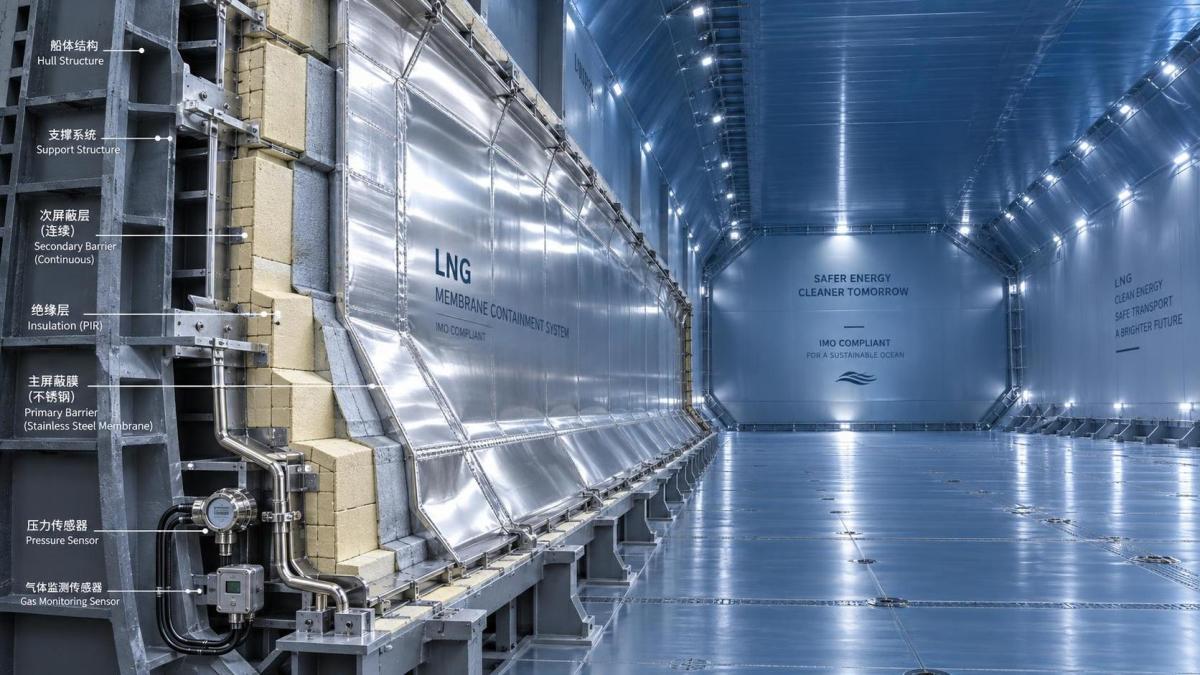

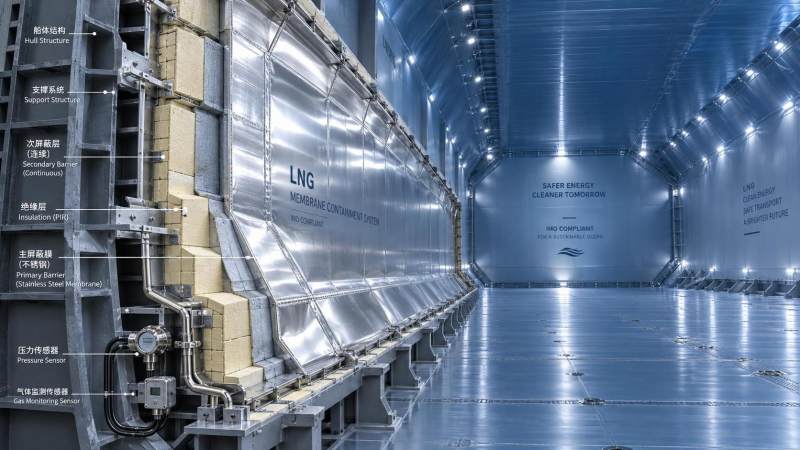

A membrane containment system is an integrated cargo tank concept in which thin metallic primary barriers retain LNG while insulation panels transfer loads to the ship’s inner hull. Unlike an independent tank, the membrane arrangement relies directly on the supporting hull structure and on carefully engineered insulation and barrier layers. The design must therefore account for cargo temperature, thermal contraction, sloshing loads, hull deflection, pressure conditions, and local damage scenarios.

IMO requirements for gas carriers focus on the safety outcome rather than treating the membrane as an isolated product. The containment system must safely carry the intended cargo, limit the consequences of a primary barrier failure, prevent harmful pressure accumulation, and provide practical means to identify abnormal conditions. Compliance also depends on the vessel-level systems around the tank: cargo handling, vapour management, fire protection, gas detection, emergency shutdown functions, and the arrangements protecting personnel and the ship’s structure.

This distinction matters during quality review. A supplier certificate for a membrane material is useful, but it is not evidence that the installed cargo containment system complies. The relevant question is whether the approved system has been constructed, tested, and documented as a complete arrangement.

The compliance chain begins before steel cutting

The strongest compliance evidence is built into the project from the design stage. An approved containment concept normally defines the barrier configuration, insulation layout, allowable structural movement, cargo operating envelope, drainage and protection arrangements, monitoring points, and inspection access. These documents establish what fabrication teams, inspectors, class surveyors, and ship operators are expected to verify later.

Design review should examine the interfaces that are most likely to create hidden defects. A membrane panel may meet its own dimensional requirement but become vulnerable where it joins a corner region, pump tower connection, penetration, cofferdam boundary, or adjacent structural transition. These areas experience combined effects from weld shrinkage, thermal movement, local stress concentration, and access limitations during installation.

It is also important to distinguish approved deviations from informal site adjustments. Changes to insulation geometry, membrane details, adhesive application, structural support, instrumentation routing, or repair methods can affect the validated performance of the system. A deviation that seems minor from a production perspective may change thermal behaviour or secondary barrier continuity. The compliance record should show the technical basis for the change, the approval route, the inspection performed, and the final as-built condition.

Primary and secondary barriers must be verified differently

The primary barrier is the cargo-facing layer intended to retain LNG under normal operating conditions. Its integrity depends on controlled material handling, panel forming, joint preparation, welding or joining quality, and protection from damage during adjacent work. Inspection methods should be selected for the failure modes that matter: incomplete joints, pinholes, mechanical damage, distortion, contamination, or defects introduced during repair.

The secondary barrier serves a different purpose. It is not merely a backup layer that can be checked at the end of construction. It is part of the safety case for a credible loss of primary containment. Its continuity, compatibility with insulation materials, performance at cryogenic temperature, and relationship with the hull structure must be maintained through every installation stage.

A frequent mistake is to give much more attention to the visible primary membrane than to the enclosed secondary barrier. Once insulation boxes and surrounding structure conceal a secondary barrier detail, rework can become intrusive and expensive. Quality planning should therefore place hold points before close-out, with clear acceptance criteria for joints, corners, penetrations, and interfaces between installed sections.

Element What compliance evidence should show Common weak point
Primary barrier Traceable material, qualified joining method, completed inspection and accepted repairs Assuming a visually acceptable surface proves leak tightness
Secondary barrier Continuous arrangement, verified interfaces, controlled close-out records Missing evidence in inaccessible areas after insulation installation
Insulation system Correct panel type, density or configuration, bonding, support condition, and damage control Treating insulation as thermal efficiency only, rather than a load-transfer component
Hull support structure Dimensional control, weld quality, structural alignment, and approved tolerances Ignoring how structural movement transfers into membrane stresses
Monitoring arrangement Installed sensors, alarms, functional checks, calibration status, and response procedures Recording sensor installation without proving usable alarm response
How membrane containment systems demonstrate compliance with IMO standards

Fabrication control is a safety control, not a paperwork exercise

Membrane cargo tanks involve repeated installation tasks performed across a large surface area. Repetition can create false confidence. A defect pattern can be replicated quickly when tools, environmental conditions, workmanship, or inspection interpretation drift from the approved process. Effective fabrication control uses defined work sequences, qualified personnel, material identification, environmental limits where relevant, and inspection points that catch a defect before the next layer hides it.

Traceability should be usable, not merely extensive. The project team should be able to connect a specific tank zone to its material batch, installation record, inspection result, repair history, and final acceptance status. A large archive of documents is not helpful when records cannot be linked to the physical location of a concern.

Repair management deserves the same discipline as original installation. Repairs are sometimes assumed to be low-risk because they address a known defect. In reality, an unsuitable repair method can introduce a different failure mechanism, especially at thin barrier material, corners, or areas affected by prior thermal or mechanical work. The repair record should identify the defect, cause, approved method, inspection result, and whether similar locations require expanded examination.

Testing must prove the installed system, not just the components

Component tests establish that materials and subassemblies are suitable. System testing establishes that the completed ship arrangement functions as intended. Both are necessary, but they answer different questions.

For containment compliance, testing and inspection should provide confidence in barrier integrity, insulation space condition, cargo tank instrumentation, alarm paths, pressure protection, and emergency functions connected with cargo containment. The exact sequence depends on the approved design and construction stage, but the purpose remains consistent: identify leaks, abnormal pressure paths, faulty sensors, incomplete segregation, or unsafe responses before the vessel enters service.

Functional testing should be reviewed from an operational perspective. An alarm is only useful if the signal reaches the intended location, has a defined set point, is distinguishable from other alerts, and leads to a documented response. Similarly, a gas detection or pressure-monitoring arrangement is not fully demonstrated when its sensor powers up; it must be shown to detect the relevant condition and support timely action.

Cold-service readiness is another area where paperwork can become disconnected from actual risk. Materials, joints, insulation arrangements, and structural interfaces must remain suitable when exposed to LNG service temperatures. The evidence should connect the approved material system and fabrication method to the intended cryogenic duty, rather than relying on generic statements that a product is “low-temperature capable.”

Monitoring turns design compliance into operational compliance

Once an LNG carrier enters service, compliance becomes a continuing condition. The crew and shore organisation need reliable information about tank pressure, temperature trends, interbarrier conditions, cargo handling status, and abnormal gas presence. A containment system can only be managed effectively when its monitoring signals are understood in the context of normal operating behaviour.

Trend review is more valuable than reacting only to alarms. A gradual change in pressure behaviour, recurring temperature deviation, unusual consumption of inerting media, or repeated sensor fault may not prove a barrier failure. It can, however, justify a focused engineering review before the condition develops into a safety event or an off-hire dispute.

Alarm management should avoid two opposite failures. Excessively broad alarm settings can delay recognition of a developing problem; overly sensitive settings can produce nuisance alarms that operators learn to disregard. The appropriate set points and response logic must align with the approved system design, the cargo operating procedure, and the vessel’s actual operating profile.

Records should support a survey, an incident review, and a handover

Documentation is often described as a compliance requirement, but its practical value is broader. During a survey, records show that the vessel was built and maintained to an approved basis. During an incident investigation, they help distinguish between design limitations, fabrication defects, operational error, and monitoring failure. During a vessel handover, they preserve the knowledge needed to operate and maintain a system that cannot be fully inspected by direct access.

A useful containment-system dossier normally brings together approved drawings, design assumptions relevant to operation, material certificates, fabrication and inspection records, non-conformance reports, approved repairs, test results, sensor and alarm documentation, operating limits, and maintenance history. The documents should be controlled by tank and location where possible. A general certificate without spatial traceability is rarely enough to resolve a later concern.

Digital records can improve retrieval and trend analysis, but digitisation alone does not create control. The data structure needs to preserve revision status, approval history, physical location, and the relationship between a defect, its repair, and its acceptance evidence. This is particularly useful for long-life assets where the personnel involved in construction will not be the personnel responsible for later maintenance.

Where compliance reviews commonly fail

  • Checking certificates before checking interfaces. Material compliance does not prove that penetrations, corners, transitions, and secondary barrier joints were correctly installed.
  • Accepting completed work without a close-out map. Hidden areas need location-based evidence before subsequent layers prevent meaningful inspection.
  • Separating containment review from cargo-system review. Pressure control, gas detection, alarms, and emergency actions affect the safety of the containment arrangement in service.
  • Using inspection results without assessing defect trends. Repeated minor defects may point to a process issue rather than isolated workmanship errors.
  • Treating operations manuals as static documents. Procedures need to match the installed monitoring configuration, approved operating envelope, and vessel-specific emergency arrangements.

A practical review sequence before approval or handover

Start with the approved containment design and identify the performance assumptions that must be preserved: cargo condition, structural support, barrier continuity, insulation arrangement, and monitoring logic. Then compare the as-built records with that basis, paying particular attention to deviations and repairs. After that, review whether inspection and functional testing cover the interfaces between containment, cargo handling, and safety systems. The final step is to verify that operating procedures and maintenance records make the installed system manageable in service.

This sequence prevents a common compliance gap: accepting each discipline separately while missing the point where one discipline’s change affects another. A structural tolerance issue can influence insulation support; insulation work can obscure a secondary barrier defect; a sensor installation can be complete but fail to provide a meaningful operational warning.

Technical intelligence platforms such as GTOT are most useful here when they help project and vessel teams connect containment stress analysis, cryogenic-system design choices, and operating evidence rather than viewing LNG cargo tanks as isolated hardware. The decision should remain evidence-led: the system demonstrates compliance when its approved design intent can be traced through construction, testing, documentation, and daily operation.
