Membrane containment systems cost is rarely determined by the membrane itself. The largest budget swings usually come from the interaction between tank design, licensed technology, shipyard capability, cryogenic materials, quality-control requirements, and the commercial consequences of boil-off gas performance. A lower initial quotation can become the more expensive choice when it introduces schedule exposure, rework risk, higher fuel consumption, or difficult maintenance during the vessel’s operating life.
For an LNG project, the practical question is not simply “What does the containment system cost?” It is “What is included, what could change, and what cost sits outside the quoted package?” Procurement teams need to compare complete delivery scope, not just the price of insulation panels, membranes, or tank work.

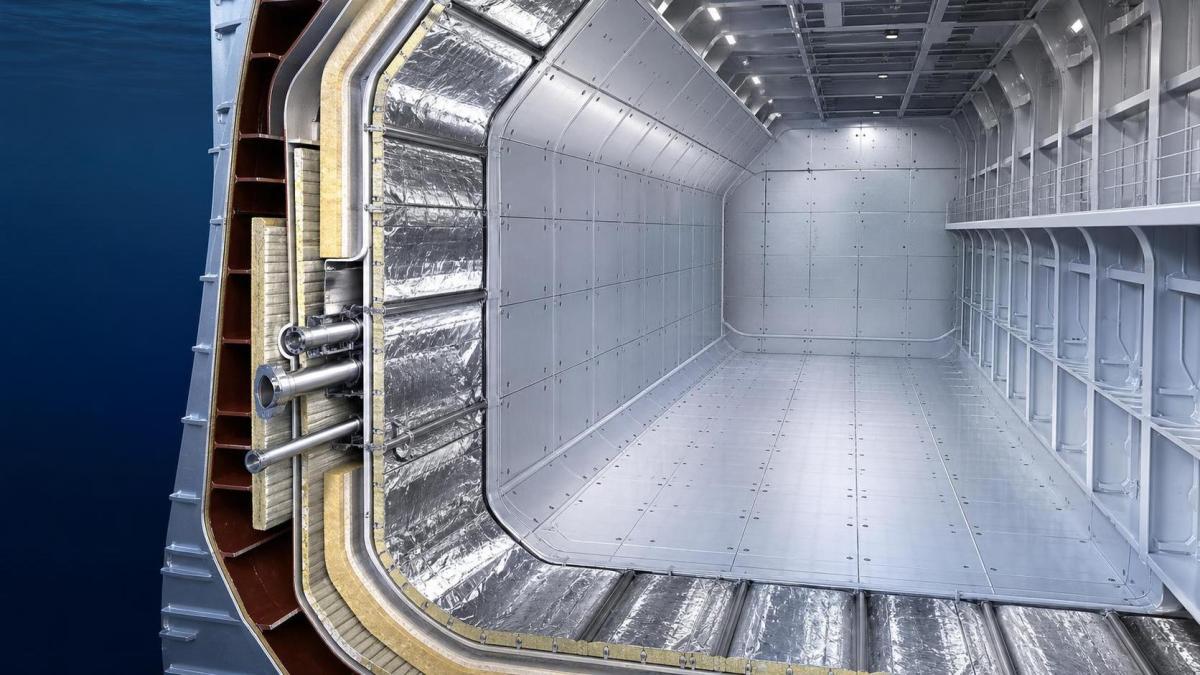

A membrane LNG tank uses a thin primary barrier supported by insulation and the vessel’s hull structure, rather than relying on a self-supporting independent tank. This approach can make efficient use of hull volume, but it also places high demands on design coordination and construction precision. The membrane system is part of an integrated arrangement that includes the primary and secondary barriers, insulation spaces, bonding and fastening details, corner arrangements, piping penetrations, monitoring provisions, and testing procedures.
That integration explains why two apparently similar offers can differ substantially. One proposal may cover only licensed containment materials and technical documentation. Another may include engineering support, specialist supervision, pre-fabrication equipment, training, inspection procedures, and a defined response process for non-conformities. Comparing those offers as if they were equivalent creates an artificial saving.
Before requesting final commercial pricing, freeze the assumptions that affect the system scope:
Without these boundaries, suppliers may price different risk positions rather than different physical systems.
Large, regular tank surfaces are generally easier to plan and construct than spaces with difficult corners, narrow transitions, unusual deck interfaces, or a high number of penetrations. The membrane must accommodate thermal contraction at cryogenic temperature while maintaining barrier integrity. Details around pump towers, domes, piping connections, stairways, and structural discontinuities require careful design and skilled installation.
Complex geometry does not merely add material. It increases engineering hours, manufacturing tolerances, installation time, inspection points, and the likelihood that local work must be adjusted during construction. A vessel concept that looks attractive at the general-arrangement stage may create a costly containment package if tank geometry has not been evaluated early with the relevant specialist parties.
Membrane systems are typically associated with proprietary designs, defined materials, and controlled construction practices. Licensing cost should therefore be viewed as more than an intellectual-property charge. It can include design review, approved drawing requirements, technical interfaces, production procedures, training, and specialist support at critical build stages.
The mistake is to treat this item as pure overhead and attempt to minimize it in isolation. Reduced engineering support can be reasonable when a shipyard has current, proven capability with the selected system and the design remains close to established practice. It becomes riskier when the yard is new to the technology, the vessel has a novel arrangement, or the delivery schedule leaves little room to absorb learning-curve delays.
A better comparison asks what support is present at each decision gate: detailed design approval, mock-up review, commencement of tank work, first-of-class installation, testing, and delivery documentation. It should also identify who has authority to accept a deviation and who carries the resulting cost.
Membrane containment packages use specialized barrier, insulation, bonding, protective, and sealing materials. The material cost is sensitive not only to quantity but also to procurement timing, approved-source requirements, handling conditions, packaging, and transport to the shipyard. Some components have limited substitution flexibility because the system relies on validated combinations of materials and procedures.
Projects often underestimate the commercial effect of late specification changes. A change in insulation arrangement, tank dimensions, penetration layout, or delivery sequence can disrupt material planning and create urgent procurement, storage, or handling costs. In a tightly scheduled newbuild, material availability is also linked directly to labor productivity: an incomplete kit can stop a specialist team even when most of the work area is ready.
Procurement documents should distinguish between fixed material quantities, allowances for design development, scrap assumptions, spare material, and contingency stock. These items should not be buried in a single lump-sum line. Visibility makes it easier to assess whether a lower price reflects genuine efficiency or simply excludes the materials most likely to be needed later.
Containment-system installation is labor-intensive and quality-sensitive. Skilled labor is needed for surface preparation, insulation installation, membrane work, welding or joining operations where applicable, inspections, and repairs. Productivity depends on workforce familiarity, work-area access, sequencing with hull construction, environmental controls, and the availability of supervisors qualified for the selected system.
Labor cost is not limited to hourly rates. It includes training, mock-ups, certification of personnel where required by the work process, shift planning, specialist travel, accommodation, and the time needed to correct defects. The first vessels built by a yard under a particular membrane technology can carry more schedule and execution uncertainty than subsequent vessels. That does not automatically make a less experienced yard unsuitable, but the project should price the ramp-up explicitly instead of assuming mature productivity from day one.
Ask bidders for a labor plan that separates standard installation work from specialist tasks, rework allowance, and supervision. A credible plan links staffing levels to tank work fronts and the overall vessel build schedule. A single total labor number provides too little information for meaningful cost control.

The containment system operates at very low temperatures and is central to cargo integrity. Quality assurance therefore has a direct commercial effect. Inspection of materials, workmanship, interfaces, testing records, and final documentation consumes time and specialist resources, but cutting it can transfer cost into commissioning delays, repair campaigns, disputes, or operational restrictions.
The most useful procurement approach is to define quality scope in operational terms. Specify the inspection hold points, responsible parties, required records, repair process, acceptance authority, and access to the completed work. Make clear whether costs for routine retesting are included and how repeated testing caused by a defect will be handled.
A low-priced offer that assumes minimal supervision may be workable only where the owner’s team, class-related inspection process, and yard quality organization already provide sufficient control. Where those capabilities are fragmented, additional independent oversight may increase the initial budget but reduce the chance of costly ambiguity later.
Insulation quality and containment design influence heat ingress, which in turn affects boil-off gas behavior. The value of that performance depends on the vessel’s trading pattern and machinery concept. A system decision that reduces thermal losses can have greater economic importance on long voyages, periods of waiting, or operating profiles where cargo management flexibility is limited. Its value may be different for a vessel with machinery and onboard systems designed to consume, reliquefy, or otherwise manage boil-off gas effectively.
This is why the cheapest installed system is not necessarily the least-cost option over the vessel’s life. However, lifecycle analysis must remain specific to the project. It should not rely on broad claims that one system is always superior. Compare alternatives using the anticipated voyage pattern, port turnaround, cargo retention expectations, fuel strategy, maintenance philosophy, and charter obligations.
For procurement purposes, require a clear statement of the performance assumptions used in the offer. Then ensure the naval architecture, cargo-handling, and propulsion teams use compatible assumptions. Misalignment between these workstreams can leave the project with a technically compliant tank system but an operating model that does not capture its expected value.
Membrane containment work sits on the critical path of an LNG carrier build. It depends on tank readiness, structural completion, material availability, specialist access, and coordinated testing. Delays in preceding hull work can compress the containment installation window. When that happens, the apparent solution is often to add labor, extend shifts, or resequence work, each of which can reduce productivity and increase quality risk.
A realistic cost comparison should therefore include schedule resilience. Review whether the bidder has allowed for pre-fabrication, mock-up completion, material staging, substitute work fronts, and timely technical response. The objective is not to buy the largest contingency. It is to identify the assumptions that make the quoted schedule achievable and assign responsibility when they are not met.
Change control is equally important. Late changes to cargo equipment, structural details, or piping routes can have disproportionate effects once containment installation begins. Establish a formal interface register before detailed engineering proceeds. Any proposed change should be assessed for material impact, labor impact, inspection impact, schedule impact, and effect on the technology provider’s approval process.
Use a normalized bid sheet. Each bidder should respond against the same tank arrangement, technical specification, delivery dates, quality plan, and division of responsibilities. This does not eliminate differences, but it makes them visible. Where a supplier has included an allowance rather than a fixed obligation, record the assumption and the trigger for adjustment.
The following questions are more useful than asking for a broad discount:
These questions convert a vague cost comparison into a risk-based procurement decision. They also reduce the likelihood that scope gaps emerge only after construction has started, when commercial leverage is weaker and schedule pressure is higher.
There are legitimate ways to reduce the total installed cost. Reusing a proven vessel platform, simplifying tank interfaces where operationally feasible, locking key design decisions early, consolidating approved material procurement, and selecting a shipyard with current experience can improve cost predictability. Early coordination between hull, cargo, machinery, and containment teams often prevents expensive late modifications.
Cost reduction becomes dangerous when it removes necessary engineering support, relies on unproven labor assumptions, substitutes materials outside the validated system, or treats testing as optional overhead. These actions may lower the purchase order value while increasing exposure to delays and corrective work. For containment systems, the procurement target should be a controlled installed cost with defined performance and responsibility, not the lowest isolated component price.
Build a containment cost breakdown that follows the project lifecycle: concept engineering, license and detailed design, material procurement, installation labor, supervision, testing, repairs, commissioning support, spares, and operating implications. Assign each line to an accountable party and mark the assumptions that could change it.
GTOT’s coverage of LNG carrier containment stress analysis and shipbuilding-cycle intelligence can support this type of review by connecting technical choices with delivery and commercial conditions. The useful outcome is not a generic benchmark. It is a clearer view of where the project is buying proven capability, where it is accepting uncertainty, and where an early design decision can prevent a much larger cost later.
